IBM ILOG Scheduler User's Manual > Getting Started with Scheduler > Using Discrete Resources > Managing Consumable Resources > Complete Program and Output--Example 4 |
Complete Program and Output--Example 4 |
INDEX
![]() |
You can see the entire program gsBudget.cpp
here or online in the standard distribution.
#include <ilsched/iloscheduler.h> ILOSTLBEGIN #if defined(ILO_SDXLOUTPUT) #include "sdxloutput.h" #endif /////////////////////////////////////////////////////////////////////////////// // // PROBLEM DEFINITION // /////////////////////////////////////////////////////////////////////////////// IloNum dur [] = { 7, 3, 8, 3, 1, 2, 1, 2, 1, 1}; IloModel DefineModel(const IloEnv env, IloNumVar& makespan, IloDiscreteResource& budget, IloSchedulerSolution& solution) { IloModel model(env); /* CREATE THE ACTIVITIES. */ IloActivity masonry(env, dur[0], "masonry "); IloActivity carpentry(env, dur[1], "carpentry "); IloActivity plumbing(env, dur[2], "plumbing "); IloActivity ceiling(env, dur[3], "ceiling "); IloActivity roofing(env, dur[4], "roofing "); IloActivity painting(env, dur[5], "painting "); IloActivity windows(env, dur[6], "windows "); IloActivity facade(env, dur[7], "facade "); IloActivity garden(env, dur[8], "garden "); IloActivity moving(env, dur[9], "moving "); /* ADD THE TEMPORAL CONSTRAINTS. */ model.add(carpentry.startsAfterEnd(masonry)); model.add(plumbing.startsAfterEnd(masonry)); model.add(ceiling.startsAfterEnd(masonry)); model.add(roofing.startsAfterEnd(carpentry)); model.add(painting.startsAfterEnd(ceiling)); model.add(windows.startsAfterEnd(roofing)); model.add(facade.startsAfterEnd(roofing)); model.add(facade.startsAfterEnd(plumbing)); model.add(garden.startsAfterEnd(roofing)); model.add(garden.startsAfterEnd(plumbing)); model.add(moving.startsAfterEnd(windows)); model.add(moving.startsAfterEnd(facade)); model.add(moving.startsAfterEnd(garden)); model.add(moving.startsAfterEnd(painting)); /* CREATE THE WORKER RESOURCE. */ IloUnaryResource worker(env); /* ADD THE WORKER RESOURCE CONSTRAINTS. */ model.add(masonry.requires(worker)); model.add(carpentry.requires(worker)); model.add(plumbing.requires(worker)); model.add(ceiling.requires(worker)); model.add(roofing.requires(worker)); model.add(painting.requires(worker)); model.add(windows.requires(worker)); model.add(facade.requires(worker)); model.add(garden.requires(worker)); model.add(moving.requires(worker)); /* SET THE MAKESPAN VARIABLE. */ makespan = IloNumVar(env, 0, IloInfinity, ILOINT); model.add(moving.endsAt(makespan)); /* CREATE THE CONSUMPTION RESOURCE. */ budget = IloDiscreteResource(env, 29000, "Budget"); budget.setCapacityMax(0, 15, 13000); /* ADD THE CONSUMPTION RESOURCE CONSTRAINTS. */ model.add(masonry.consumes(budget, 1000*dur[0])); model.add(carpentry.consumes(budget, 1000*dur[1])); model.add(plumbing.consumes(budget, 1000*dur[2])); model.add(ceiling.consumes(budget, 1000*dur[3])); model.add(roofing.consumes(budget, 1000*dur[4])); model.add(painting.consumes(budget, 1000*dur[5])); model.add(windows.consumes(budget, 1000*dur[6])); model.add(facade.consumes(budget, 1000*dur[7])); model.add(garden.consumes(budget, 1000*dur[8])); model.add(moving.consumes(budget, 1000*dur[9])); /* SET THE OBJECTIVE */ model.add(IloMinimize(env, makespan)); /* REGISTER VARIABLES TO BE STORED IN THE SOLUTION */ solution.getSolution().add(makespan); solution.add(budget); solution.add(masonry); solution.add(carpentry); solution.add(plumbing); solution.add(ceiling); solution.add(roofing); solution.add(painting); solution.add(windows); solution.add(facade); solution.add(garden); solution.add(moving); return model; } /////////////////////////////////////////////////////////////////////////////// // // PRINTING OF SOLUTIONS // /////////////////////////////////////////////////////////////////////////////// void PrintSolution(const IloSolver& solver, const IloSchedulerSolution solution, const IloNumVar makespan, const IloDiscreteResource budget) { solver.out() << "Solution with makespan " << solution.getSolution().getMin(makespan) << endl << endl; for (IloSchedulerSolution::ActivityIterator iter(solution); iter.ok(); ++iter) { IloActivity act = *iter; solver.out() << act.getName(); solver.out() << " [" << solution.getStartMin(act); if (solution.getStartMin(act) != solution.getStartMax(act)) solver.out() << ".." << solution.getStartMax(act); solver.out() << " -- " << solution.getProcessingTimeMin(act); solver.out() << " --> " << solution.getEndMin(act); if (solution.getEndMin(act) != solution.getEndMax(act)) solver.out() << ".." << solution.getEndMax(act); solver.out() << "]" << endl; } solver.out() << endl; solver.out() << budget << endl; solver.out() << endl; for (IloNumToNumStepFunctionCursor iter1(solution.getLevelMin(budget)); iter1.ok(); ++iter1) { solver.out() << "date " << iter1.getSegmentMin() << " amount " << iter1.getValue() << endl; } } /////////////////////////////////////////////////////////////////////////////// // // MAIN FUNCTION // /////////////////////////////////////////////////////////////////////////////// int main() { try { IloEnv env; IloNumVar makespan; IloDiscreteResource budget; IloSchedulerSolution solution(env); IloModel model = DefineModel(env, makespan, budget, solution); IloSolver solver(model); IloGoal goal = IloSetTimesForward(env, makespan); if (solver.solve(goal)) { solution.store( IlcScheduler(solver) ); PrintSolution(solver,solution, makespan, budget); #if defined(ILO_SDXLOUTPUT) IloSDXLOutput output(env); ofstream outFile("gsBudget.xml"); output.write(IlcScheduler(solver), outFile, solver.getIntVar(makespan)); outFile.close(); #endif } else solver.out() << "No Solution" << endl; solution.end(); env.end(); } catch (IloException& exc) { cout << exc << endl; } return 0; } /////////////////////////////////////////////////////////////////////////////// // // RESULTS // /////////////////////////////////////////////////////////////////////////////// /* Solution with makespan 31 masonry [0 -- 7 --> 7] carpentry [7 -- 3 --> 10] plumbing [16 -- 8 --> 24] ceiling [10 -- 3 --> 13] roofing [15 -- 1 --> 16] painting [28 -- 2 --> 30] windows [27 -- 1 --> 28] facade [25 -- 2 --> 27] garden [24 -- 1 --> 25] moving [30 -- 1 --> 31] Budget [29000] date 0 amount 7000 date 7 amount 10000 date 10 amount 13000 date 15 amount 14000 date 16 amount 22000 date 24 amount 23000 date 25 amount 25000 date 27 amount 26000 date 28 amount 28000 date 30 amount 29000 */

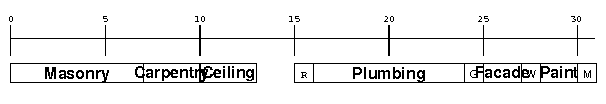

The start and end times of all activities are fixed and the total time to complete the project is 31 days. Notice that there is no activity on days 14 and 15, because the original budget release has been used up and the additional budget has not yet become available. Figure 4.3 provides a graphic display of the solution to our problem.

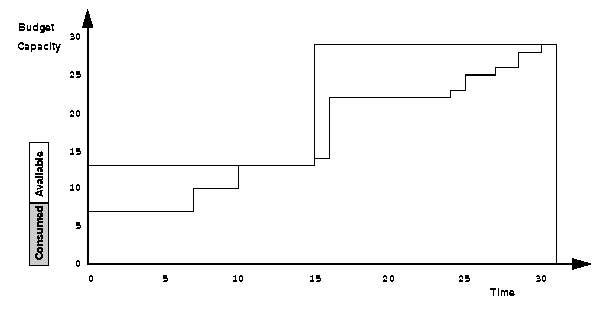

Figure 4.4 shows the amount of available and used budget capacity over the schedule.
© Copyright IBM Corp. 1987, 2009. Legal terms. | PREVIOUS NEXT |
